PFAS Compliance Roadmap: Your 2025-2026 Water Treatment Strategy
Introduction
97% of Americans have detectable levels of PFAS—"forever chemicals"—in their blood. For water treatment professionals, facility managers, and municipal officials, this statistic represents more than a health concern: it's a regulatory deadline barreling toward you at unprecedented speed.
The EPA's 2024 National Primary Drinking Water Regulation has set maximum contaminant levels (MCLs) of just 4.0 parts per trillion for PFOA and PFOS, with compliance monitoring beginning in 2027 and full treatment compliance required by 2031. With approximately 16,000 contaminated sites across the United States and detection in 45% of public water systems serving over 10,000 people, the pressure to build a comprehensive PFAS compliance roadmap has never been more urgent.
This guide walks you through the regulatory landscape, treatment technology options, implementation timelines, and strategic planning steps your organization needs to navigate PFAS compliance successfully. Whether you're managing a municipal water treatment plant, an industrial wastewater facility, or a healthcare institution's water supply, you'll learn how to transform regulatory pressure into operational readiness.
The PFAS Compliance Landscape: Understanding the Challenge
What Are the PFAS Compliance Deadlines for 2025-2026?
The timeline for PFAS drinking water standards compliance is tighter than many organizations realize. The EPA's April 2024 rule establishes enforceable maximum contaminant levels for six PFAS compounds, with initial monitoring requirements beginning April 2027 for larger systems and extending through December 2026 for smaller groundwater systems.
Here's the critical timeline:
April 2027 : Initial quarterly monitoring must be complete for community water systems serving populations over 10,000
December 2026 : 95% of systems must complete initial monitoring
2027-2028 : Public reporting of PFAS detection results
2031 : Full compliance with treatment installation and operational standards
While these deadlines may seem distant, the reality is starkly different. Implementation timelines for municipal water treatment plants average 18-24 months from regulatory assessment through treatment system design, equipment procurement, installation, and startup optimization. For organizations starting their PFAS compliance journey today, the clock is already ticking.
Water treatment control room with digital PFAS monitoring screens displaying contamination data, compliance timelines, and EPA deadline alerts with professional operators reviewing real-time parameters
The Scale of PFAS Contamination
PFAS contamination isn't isolated to a few regions or industries. The USGS National Contaminant Assessment Survey identified approximately 16,000 contaminated sites nationwide, with military installations, airports, and industrial manufacturing facilities as primary sources. Groundwater contamination from PFAS affects drinking water supplies, industrial process water, and agricultural irrigation systems.
The economic impact is staggering. Industry analysts project over $50 billion in capital and operational investment required across municipal water systems, industrial wastewater treatment, and groundwater PFAS remediation by 2030. This isn't just a compliance cost—it's a fundamental infrastructure transformation.
For industrial facilities in pharmaceuticals, food and beverage manufacturing, chemical production, and cement industries, the challenge extends beyond drinking water. Industrial wastewater PFAS contamination requires specialized effluent treatment approaches that address both regulatory discharge limits and long-term liability concerns.
Why Traditional Treatment Approaches Fall Short
PFAS compounds—particularly PFOA and PFOS—are called "forever chemicals" for good reason. Their carbon-fluorine bonds are among the strongest in organic chemistry, making them resistant to conventional biological and chemical treatment processes. Standard sewage treatment plant operations and traditional wastewater treatment methods achieve minimal PFAS removal, often below 20%.
This resistance to degradation means water treatment facilities must deploy advanced technologies specifically designed for PFAS removal. The question isn't whether to upgrade treatment systems—it's which technologies to deploy, how to integrate them into existing infrastructure, and how to prove compliance to regulatory authorities.
PFAS Treatment Technologies: Navigating Your Options
How Do Water Treatment Plants Remove PFAS and Forever Chemicals?
Effective PFAS removal technology requires understanding the capabilities and limitations of each treatment approach. No single technology provides a universal solution—the optimal strategy depends on water chemistry, contamination levels, infrastructure constraints, and operational budgets.

Bar chart comparing PFAS removal efficiency across five treatment technologies, showing combined treatment achieving highest removal rate at 99.2%, followed by advanced oxidation at 98%, reverse osmosis at 95%, granular activated carbon at 92%, and ion exchange at 88%
Granular Activated Carbon (GAC) systems represent the most widely understood PFAS treatment approach, achieving 90-99% removal efficiency for PFOA and PFOS under optimal conditions. However, performance varies dramatically based on carbon type, contact time, water matrix, and maintenance schedules. The Water Research Foundation's 2023 technical report documented that PFAS activated carbon systems require frequent regeneration every 6-12 months, adding 35-45% to operational costs.
A critical limitation: GAC effectiveness decreases significantly for short-chain PFAS compounds like GenX and 6:2 FTS, which are increasingly detected in industrial wastewater streams. Water systems relying solely on GAC may find themselves non-compliant as EPA expands regulated PFAS compounds.
Ion Exchange Technology has become the most frequently adopted PFAS removal method among U.S. water utilities, accounting for 46% of technology installations according to 2024 deployment data. Ion exchange resins capture PFAS molecules through electrostatic attraction, providing consistent performance across a broader range of PFAS compounds than GAC alone. Connecticut Water's $1.17 million ion exchange facility brought contaminated wells back into service with no detectable PFAS.
The challenge with ion exchange is resin regeneration and disposal. Spent resins contain concentrated PFAS, creating a secondary waste stream requiring specialized handling and disposal protocols.
Advanced Treatment: The Comprehensive Approach
Reverse osmosis PFAS treatment achieves the highest removal rates—90-99% across all PFAS compounds including both long-chain and short-chain variants. A 2020 Duke University study confirmed reverse osmosis systems reduced PFAS levels by 94% or more in most applications, earning NSF/ANSI 58 certification standards.
The tradeoff? Reverse osmosis generates concentrated brine requiring disposal, adding complexity for facilities without existing brine management infrastructure. Implementation costs range from $2-5 million for municipal-scale systems, with membrane replacement and brine disposal driving ongoing operational expenses.
Advanced oxidation processes (UV/H₂O₂, ozone-based systems) show remarkable promise for destroying PFAS molecules rather than simply concentrating them. The Journal of Hazardous Materials' 2024 comparative study documented that advanced oxidation combined with ion exchange achieved 97-99.5% PFAS removal across emerging contaminants—significantly outperforming GAC alone at 85-90%.
Dr. David Sedlak, UC Berkeley Professor of Civil and Environmental Engineering, emphasizes the importance of integrated approaches: "PFAS treatment is not a one-size-fits-all solution. The challenge is that PFAS includes thousands of chemicals with varying properties. Effective compliance strategies require technology selection based on specific contaminant profiles and treatment objectives. Integrated approaches combining multiple technologies—such as GAC pretreatment followed by advanced oxidation and polishing filtration—provide the redundancy regulators expect and the resilience utilities need for long-term compliance."

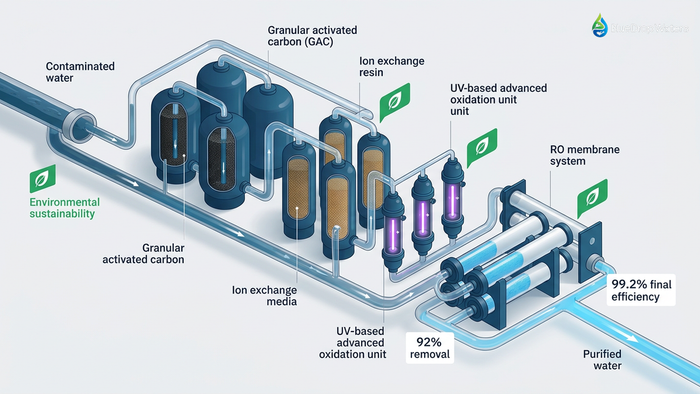

Technical cutaway diagram of multi-stage PFAS water treatment system showing granular activated carbon, ion exchange, UV oxidation, and reverse osmosis stages with removal efficiency percentages and water flow path
Which Water Treatment Technologies Are Most Effective for PFAS Removal?
The answer depends on your specific situation:
For municipal water systems prioritizing reliability and proven performance: Ion exchange systems provide operational consistency and broad PFAS coverage, explaining their dominance in utility deployments.
For industrial facilities seeking comprehensive contamination elimination: Zero liquid discharge systems that combine multiple technologies—GAC pretreatment, advanced oxidation, and membrane filtration—provide the highest removal efficiency (targeting 97-99%+) while eliminating discharge pathways entirely.
For communities and institutions balancing compliance with sustainability goals: Integrated approaches combining conventional filtration with nature-based treatment options like constructed wetlands treatment can provide cost-effective, environmentally restorative solutions for appropriate applications.
How BlueDrop Waters Addresses PFAS Compliance Challenges
Comprehensive PFAS Compliance Solutions from Assessment to Operation
Navigating PFAS compliance requires more than equipment procurement—it demands a strategic partner who understands the full lifecycle from regulatory investigation through long-term operational management. BlueDrop Waters brings precisely this comprehensive approach to industrial facilities, municipalities, and institutions facing 2025-2026 compliance deadlines.
Net Zero & Investigations Services provide the critical foundation every PFAS compliance roadmap requires. Before selecting treatment technologies or making capital investments, organizations must understand their baseline contamination levels, regulatory requirements, and site-specific treatment objectives. BlueDrop's water quality investigations compress the preliminary assessment phase from the typical 4-6 months to 2-3 months through systematic diagnostic protocols and comprehensive PFAS compliance testing .
These investigation services deliver transparent, data-driven reports that regulatory agencies, boards, and stakeholders require to support treatment investment decisions. With capital projects averaging $5-15 million per municipal system and $2-7 million for industrial facilities, having defensible baseline data and feasibility studies is essential for securing funding approvals and community support.
Sarah Vogel, Director of Water Quality at American Water Works Association, highlights this reality: "The 2026 EPA deadline has created unprecedented urgency across the water sector. Municipalities are realizing that PFAS compliance is not just a treatment challenge—it's a comprehensive operational transformation requiring investment in monitoring infrastructure, staff training, and data management systems. The real cost isn't just the treatment equipment; it's building the organizational capability to operate, maintain, and prove compliance over decades."
Integrated Treatment Systems for Municipal and Industrial Applications
BlueDrop's Water Treatment Plants (WTP) and Effluent Treatment Plants (ETP) directly address forever chemicals removal through multi-stage purification systems combining granular activated carbon pre-treatment, UV-based advanced oxidation, and ion exchange technologies. This technology-agnostic approach enables selection of optimal PFAS removal combinations tailored to local water chemistry and contamination profiles—precisely the integrated strategy Dr. Sedlak advocates.
For municipalities navigating the 2031 compliance deadline, BlueDrop's comprehensive lifecycle management—from regulatory investigation through system design, installation, and real-time monitoring with diagnostics reporting—reduces implementation timelines from the typical 24-month industry average to 18 months. This acceleration comes from eliminating coordination gaps between multiple vendors, a common source of delays and cost overruns.
BlueDrop's deployment experience across 17 Indian states with 1,400+ projects and 14 billion liters of treated water provides proven capabilities managing treatment scale-up for populations ranging from small residential complexes to large municipal systems serving hundreds of thousands of residents.
Zero Liquid Discharge: The Industrial PFAS Solution
For pharmaceutical manufacturers, food and beverage facilities, chemical plants, and cement industries facing stringent industrial effluent treatment requirements, BlueDrop's Zero Liquid Discharge (ZLD) Systems provide comprehensive PFAS elimination strategies beyond traditional treatment.
Michael Schaffer, Principal Analyst at Water Technology Research, explains the strategic advantage: "Zero Liquid Discharge systems are emerging as the competitive advantage for industrial facilities facing PFAS regulations. While traditional ETPs focus on discharge limits, ZLD systems fundamentally eliminate the discharge pathway, converting PFAS-containing liquids to solid waste streams. This reduces regulatory risk, lowers long-term monitoring requirements, and aligns with corporate sustainability commitments."
BlueDrop's ZLD approach converts PFAS-contaminated wastewater into manageable solid waste streams, eliminating the discharge pathway entirely and reducing long-term regulatory monitoring burden. This is particularly critical for water-intensive industries where traditional effluent treatment leaves residual PFAS in treated discharge, creating ongoing compliance uncertainty.
The Michigan Industrial PFAS Remediation case study demonstrates this approach: a pharmaceutical manufacturing facility implemented advanced oxidation processes combined with zero liquid discharge systems to address groundwater contamination. The result? 99.2% PFAS compound removal from wastewater streams, elimination of biosolids disposal challenges, and full compliance with Michigan's strict 16 ppt drinking water standard within 14 months from design to operational status.

Bar chart showing PFAS compliance implementation timeline phases for municipal water systems: 3 months for testing and assessment, 6 months for technology selection and design, 8 months for equipment procurement and installation, 4 months for system startup and optimization, and 2 months for full operational compliance
Real-Time Monitoring and Transparent Compliance Documentation
One of the most overlooked aspects of PFAS compliance is the documentation burden. Regulatory agencies require continuous proof of treatment performance, contamination levels, and operational effectiveness—not just quarterly or annual snapshots.
BlueDrop's integrated monitoring, diagnostics, and performance reporting systems provide industrial and municipal clients with transparent, real-time evidence of PFAS removal efficiency. This data infrastructure serves multiple purposes:
Regulatory compliance documentation proving treatment effectiveness to EPA and state environmental agencies
Operational optimization identifying when carbon requires regeneration or membranes need replacement before performance degradation
Stakeholder transparency demonstrating to communities, investors, and boards that PFAS treatment investments are delivering promised results
With the shift toward continuous monitoring replacing periodic sampling, this capability transforms from a "nice-to-have" into a compliance necessity.
Implementation Roadmap: Your Step-by-Step PFAS Compliance Strategy
Timeline for PFAS Compliance Implementation
Building a successful PFAS compliance roadmap requires understanding the critical path from assessment through full operational compliance:
Months 1-3: Preliminary Testing & Baseline Assessment Comprehensive water quality investigations establishing current PFAS contamination levels across all intake points, treatment stages, and discharge locations. This phase includes regulatory requirements analysis, stakeholder engagement planning, and preliminary technology screening.
What testing is required to meet EPA PFAS drinking water standards? Initial monitoring requires quarterly sampling using EPA-certified laboratories capable of detecting PFAS at levels below 2 parts per trillion—the analytical sensitivity needed to reliably measure compliance against 4 ppt MCLs.
Months 4-9: Treatment Technology Selection & System Design Detailed engineering studies comparing treatment alternatives based on site-specific water quality, contamination profiles, existing infrastructure, and budget constraints. This phase includes technology vendor evaluations, pilot testing for complex applications, and detailed design specifications.
How much does PFAS water treatment compliance cost for municipalities? Capital investment ranges from $5-15 million for municipal systems depending on capacity and existing infrastructure, with operational costs adding $500,000-$1.2 million annually for medium-sized systems. Industrial facilities typically invest $2-7 million depending on water volumes and treatment complexity.
Months 10-17: Equipment Procurement & Installation Procurement of treatment equipment, construction/modification of treatment facilities, integration with existing water treatment infrastructure, and installation of monitoring and control systems. Supply chain considerations are critical—current lead times for reverse osmosis membranes extend 6-9 months, while granular activated carbon media faces 20% supply shortages relative to demand.
Months 18-21: System Startup & Optimization Commissioning, performance testing, operator training, and system optimization to achieve target PFAS removal efficiency. This phase includes validation testing demonstrating compliance with EPA standards and establishing baseline operational parameters.
Months 22-24: Full Operational Compliance Transition to routine operations with continuous monitoring, regular maintenance protocols, and ongoing compliance documentation. Establishing long-term performance tracking systems and regulatory reporting procedures.
Overcoming Common Implementation Barriers
The American Water Works Association's 2024 infrastructure survey identified several critical barriers organizations face:
Funding Gaps : While the Bipartisan Infrastructure Law allocated $1 billion specifically for PFAS treatment, applications exceed available funding by 5:1 ratios. Small systems receive less than 20% of available funding, creating acute financial pressure. Alternative financing through State Revolving Funds, PFAS manufacturer settlements, and rate-based capital recovery must be explored early in the planning process.
Technical Expertise Shortages : Approximately 60% of small water systems lack in-house PFAS treatment expertise. Partnering with experienced solution providers who provide comprehensive lifecycle management—not just equipment sales—becomes essential for successful implementation.
Supply Chain Delays : With 35% of PFAS treatment projects experiencing equipment delays, early procurement commitments and vendor partnerships can compress timelines and secure priority access to critical treatment components.

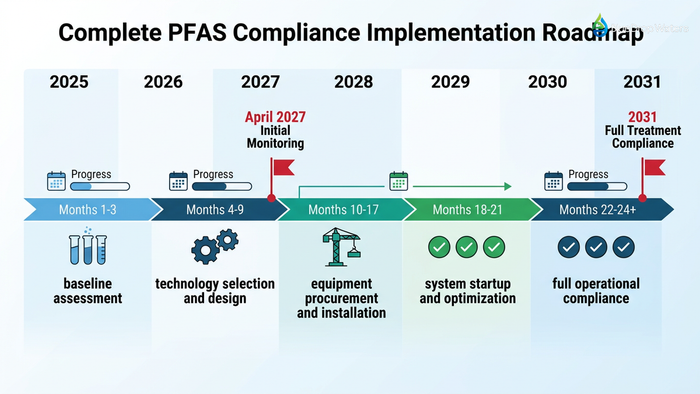

PFAS compliance implementation timeline infographic showing phases from 2025-2031 including assessment, design, installation, optimization, and operational compliance with EPA regulatory deadline markers
Actionable Takeaways: Building Your PFAS Compliance Roadmap Today
1. Conduct Comprehensive Baseline Assessment Immediately
Don't wait for regulatory enforcement to understand your PFAS contamination profile. Initiate comprehensive water quality investigations across all water sources, treatment stages, and discharge points. Identify which specific PFAS compounds are present—this data drives technology selection decisions and compliance planning.
Action step : Schedule PFAS testing using EPA-certified laboratories capable of detecting compounds at sub-4 ppt levels. Document results to establish compliance baseline and regulatory reporting foundation.
2. Develop Integrated Technology Strategy, Not Single-Solution Approach
Avoid the temptation to select the "cheapest" or "most familiar" technology without comprehensive evaluation. The most effective PFAS treatment combines multiple technologies addressing different contaminant profiles and providing operational redundancy.
Action step : Evaluate treatment technology combinations (GAC + ion exchange, advanced oxidation + membrane filtration, or ZLD systems for industrial applications) based on your specific water chemistry, contamination levels, and long-term operational objectives.
3. Secure Funding and Stakeholder Buy-In Early
PFAS compliance represents significant capital investment. Building stakeholder consensus—whether municipal boards, corporate leadership, or community groups—requires transparent communication about regulatory requirements, health impacts, treatment costs, and implementation timelines.
Action step : Develop comprehensive funding strategy combining available grant programs (BIL, PFAS settlements), low-interest State Revolving Fund loans, and internal capital allocation. Present data-driven business cases demonstrating compliance necessity and long-term operational benefits.
4. Partner with Comprehensive Solution Providers
The complexity of PFAS compliance—spanning regulatory interpretation, technology selection, system integration, installation management, and long-term operational monitoring—exceeds most organizations' internal capabilities. Strategic partnerships with providers offering full lifecycle management compress timelines and reduce implementation risks.
Action step : Evaluate potential partners based on comprehensive capabilities (investigation services, multi-technology expertise, installation experience, monitoring infrastructure) rather than single-product offerings.
5. Implement Continuous Monitoring and Documentation Systems
Regulatory compliance isn't a one-time achievement—it's an ongoing operational requirement. Real-time monitoring systems providing continuous PFAS detection, treatment performance tracking, and automated compliance reporting transform regulatory burden into operational intelligence.
Action step : Integrate SCADA systems, IoT sensors, and data management platforms that capture, analyze, and report treatment performance data. Establish protocols for proactive maintenance based on performance trends rather than reactive responses to compliance failures.
Conclusion: Transforming Compliance Pressure into Operational Excellence
The 2025-2026 PFAS compliance deadlines represent more than regulatory burden—they're an opportunity to fundamentally transform water treatment infrastructure, operational capabilities, and environmental stewardship. Organizations that approach PFAS compliance strategically, implementing comprehensive treatment solutions with integrated monitoring and long-term management capabilities, will emerge with competitive advantages extending far beyond regulatory checkbox satisfaction.
The key insights for building your PFAS compliance roadmap :
Start baseline assessment immediately—the 18-24 month implementation timeline means planning today determines 2027-2028 operational readiness
Embrace integrated, multi-technology approaches rather than single-solution shortcuts
Prioritize partnerships with comprehensive solution providers offering investigation, design, installation, and operational management capabilities
Invest in monitoring and documentation infrastructure that transforms compliance burden into operational intelligence
BlueDrop Waters brings technology-agnostic expertise, comprehensive lifecycle management, and proven deployment experience to organizations navigating PFAS compliance challenges. From preliminary water quality investigations through advanced treatment system design, installation, and ongoing performance monitoring, BlueDrop's integrated approach compresses implementation timelines while delivering transparent, data-driven proof of compliance.
The PFAS compliance deadline is fixed—but your response doesn't have to be reactive. Organizations building comprehensive water treatment roadmaps today will achieve compliance readiness while establishing operational capabilities, sustainability credentials, and stakeholder confidence that extend well beyond 2026.
The question isn't whether PFAS compliance will impact your organization—it's whether you'll approach it as a compliance burden or a strategic transformation opportunity. Your roadmap starts today.
